Calvin Smith Excavating installs new conventional gravity septic systems for residential properties across southwest Missouri. We’re Missouri DHSS-registered (#39658) and handle the full project — site walk, soil evaluation coordination, permit application, excavation, tank install, drainfield construction, final inspection, and as-built drawing. Costs vary based on soil conditions, system type, and site access — call (417) 719-0643 for a free site walk and itemized quote.

Advanced (aerobic) system installation begins late August 2026. Until then, we install conventional systems and handle all repair scopes on existing systems of any type.

Mitzi Albert
Mitzi Albert
Calvin has cleared a larger chunk of our field. Cleared lots of thorn trees pushed into burn pile as we asked! Did a great job and we are very happy with work he did! For sure will get called again
Amber Murray
Amber Murray
Calvin brought us a load of gravel after the recent storms and took the time to spread it out evenly.

Schedule a Free Site Walk

Tell us about your property, county, and install timeline. We will follow up to schedule your free on-site evaluation.

What Conventional Septic Installation Includes

A standard residential install covers everything from the site walk through the final inspection and as-built filing.

A standard residential install covers:

  • Site walk and quote
  • Coordination of soil evaluation (perc test) with a certified evaluator or county health department
  • County health department permit application and approval
  • Excavation for tank and drainfield trenches
  • Concrete tank purchase and installation (typically 1,000–1,500 gallon for residential)
  • Inlet/outlet baffles and risers
  • Drainfield construction — gravel-and-pipe or chamber-based, depending on design
  • Distribution box and line connections
  • Backfill, final grading, and seeding of disturbed areas
  • County health department final inspection
  • As-built drawing filed with the county

Free Site Walk & Itemized Quote

That range moves based on soil, rock, tank size, drainfield size, access, and whether the system needs pumping equipment instead of pure gravity flow.

Until late August 2026: conventional systems only. If your site requires advanced treatment before then, Calvin can coordinate with a registered installer while still handling the excavation portion of the work.

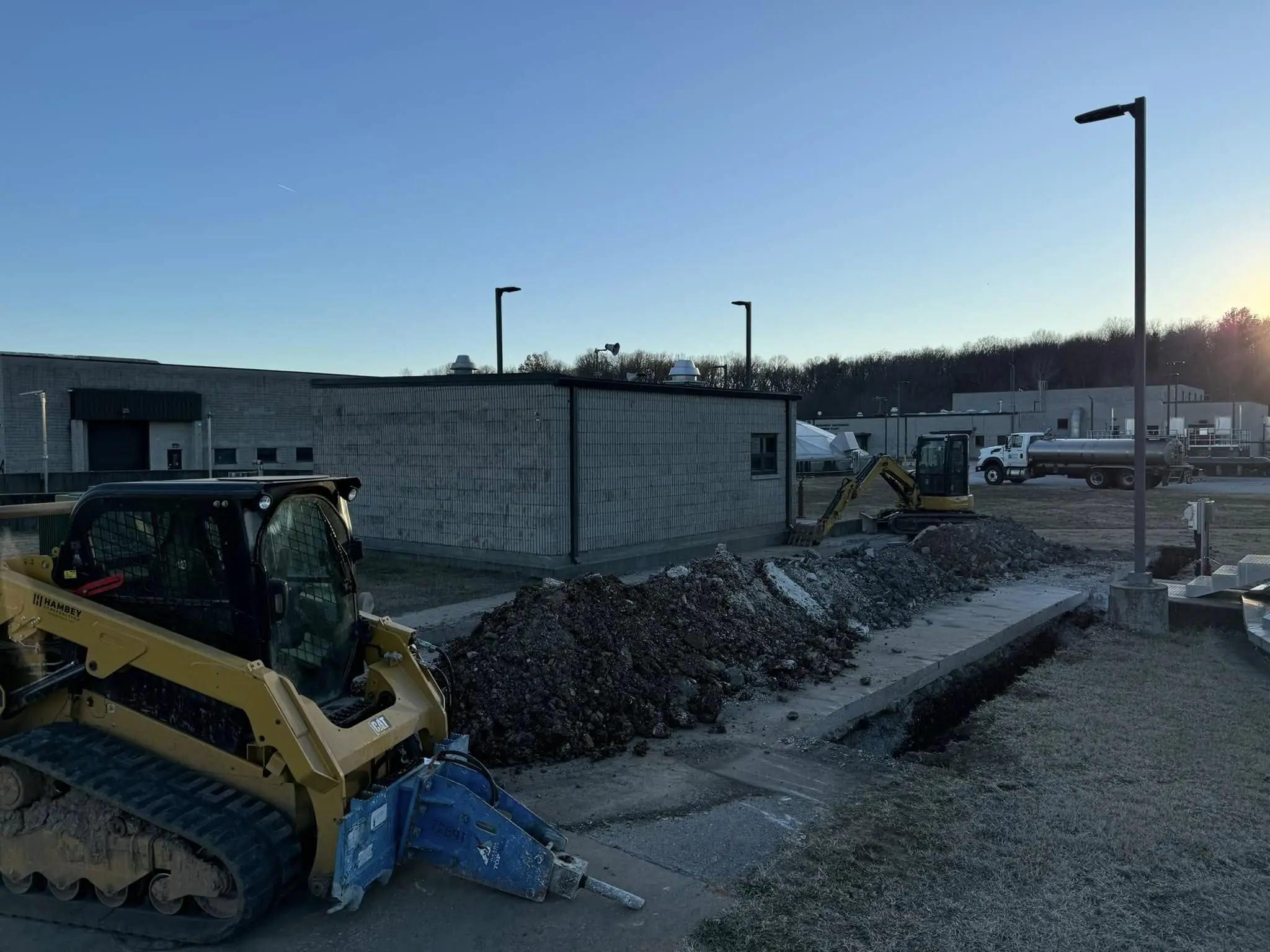

Yellow track loader and mini excavator digging along a dirt trench beside a concrete block building at sunrise

What's Driving Cost on Your Specific Site

Several factors move the final quote, and they usually show up clearly during the site walk and soil evaluation stage.

Soil and rock

Ozarks limestone bedrock close to the surface adds excavation cost. Drainfield depth is constrained by what’s underneath.

Drainfield size

Faster-percolating soil needs less drainfield area. Slow-percolating clay needs more — sometimes a lot more. A 3-bedroom home in good soil might need 1,500 sq ft of drainfield; the same home on poor soil might need 2,500+ sq ft.

Distance from house

The line from the house to the tank should be as short as practical. Long runs (75–100+ feet) add cost.

Equipment access

Open sites are faster to work. Tight gates, mature trees, or structures in the way slow everything down.

Tank type and size

1,000-gallon is standard for a 3-bedroom; 1,250–1,500 for larger homes. Concrete is the typical residential choice in SW Missouri.

Pump systems

If gravity won’t carry effluent to the drainfield, a pump is required. Adds equipment, electrical, and ongoing service considerations.

Permits and Soil Testing

Before any tank goes in the ground, the soil evaluation and county permit have to come first. We coordinate the testing and prepare the application.

Soil evaluation (perc test)

A certified soil evaluator visits the site, digs test pits, and determines what system can legally be installed. Some counties handle this in-house; others require a private evaluator.

Permit application

Submitted to the county health department with the soil report and proposed system design. Approval typically takes 2–4 weeks. Permit fees are paid to the county and passed through on your final invoice.

Both costs are separate from the installation quote and have to be done first. We coordinate the soil test and prepare the permit application.

Typical SW Missouri Install Timeline

Site walk + quote

1 week

Soil evaluation / perc test

1–2 weeks

Permit application + approval

2–4 weeks

Excavation + tank install + drainfield construction

2–5 days of active work

Final inspection and as-built filing

1–2 weeks

Total elapsed time

5–10 weeks

Late summer through fall is the cleanest install window in SW Missouri. Spring (March–May) is the worst — saturated ground and rain delays.

Advanced (Aerobic) Systems — Coming Late August 2026

If your soil evaluation indicates conventional won’t work — shallow bedrock, slow percolation, high water table, small lot, or stream proximity — you’ll need an advanced treatment system. Advanced systems cost more than conventional and require ongoing service contracts.

Calvin Smith Excavating begins advanced/aerobic installation in late August 2026. Until then, if your site requires advanced and you can’t wait, we can refer you to a registered installer for the install while we handle any excavation portion of the work.

DHSS Registration and Insurance

Missouri requires installer registration for new septic installation in many counties, including Greene County. Verify any installer’s credentials before hiring:

DHSS registration

Calvin Smith Excavating is #39658.

USDOT

#4119419 (required for material hauling).

General liability insurance

Certificate available on request.

County health department familiarity

We regularly work with Greene, Polk, Christian, and Webster county health departments.

Service Area

Walnut Grove, Springfield, Republic, Bolivar, Ash Grove, Willard, Nixa, Ozark, and the surrounding southwest Missouri area within roughly a 50-mile radius of Walnut Grove.

Schedule a Free Site Walk

For a free on-site evaluation, call (417) 719-0643.

DHSS #39658 Registered

Typical residential install range

Required First

Soil evaluation cost range

We Coordinate

County permit fee range

5–10 weeks

Typical total elapsed project timeline

Schedule Your Free Septic Site Walk

Septic Installation FAQ

Questions homeowners usually ask before starting a new conventional septic install in southwest Missouri.

What does a conventional septic installation include?

A typical install includes the site walk, soil evaluation coordination, permit application, excavation, tank installation, drainfield construction, line connections, final grading, inspection, and as-built filing.

The biggest variables are soil and rock, drainfield size, distance from the house, equipment access, tank size, and whether the layout needs a pump system.

Yes. The soil evaluation and county permit come first. We coordinate the soil test and prepare the permit application as part of the process.

Active installation work usually takes 2-5 days, but the full process including soil testing and county approval typically runs about 5-10 weeks.

Most 3-bedroom homes use a 1,000-gallon concrete tank, while larger homes often need a 1,250-1,500 gallon tank depending on the design.

If the soil report shows conventional will not work, you may need an advanced treatment system. Calvin Smith Excavating starts advanced aerobic installation in late August 2026.

Calvin Smith Excavating is Missouri DHSS-registered for septic installation as #39658, carries USDOT #4119419, and can provide a general liability certificate on request.

Call (417) 719-0643 to schedule a free on-site evaluation. We will walk the site, explain the scope, and quote the work in writing.
